Walton Bypass Vehicle Bridge Installation
Public Sector

Walton Bypass Vehicle Bridge Installation

Walton-on-Trent, near Burton upon Trent, Derbyshire
  • 150m Span
  • Permanent
  • 510 tonnes Structural Steelwork

150m multi-span highway bridge over the River Trent.

For decades, the local community and economy were limited by a weight-restricted, one-way Bailey bridge across the River Trent. Where infrastructure should have been innovative, it instead became a bottleneck for the region, both literally and metaphorically.

To break this deadlock, we partnered with Vistry Group and Chasetown Civil Engineering to install a permanent solution: a high-capacity, multi-span weathering steel highway bridge.

The Challenge

Installing a new bridge was to be no simple feat. Not only did the structure need to span the River Trent, posing significant logistical challenges, but it also had to contend with a complex floodplain.

With installation scheduled for late February 2026, weather conditions became a critical factor. High winds and flooding posed immediate threats to our installation window, requiring a partner with the operational agility and technical confidence to execute under pressure.

This triple-threat environment of logistics, environment, and climate set the stage for a high-stakes installation.

The Solution & Project Highlights

Delivered through a strategic partnership between Chasetown Civil Engineering, Beaver Bridges, and Foundation Piling, this project translated complex blueprints into a physical landmark. As the specialist installation lead, we provided the heavy-lift expertise and technical oversight necessary to execute this high-spec crossing.

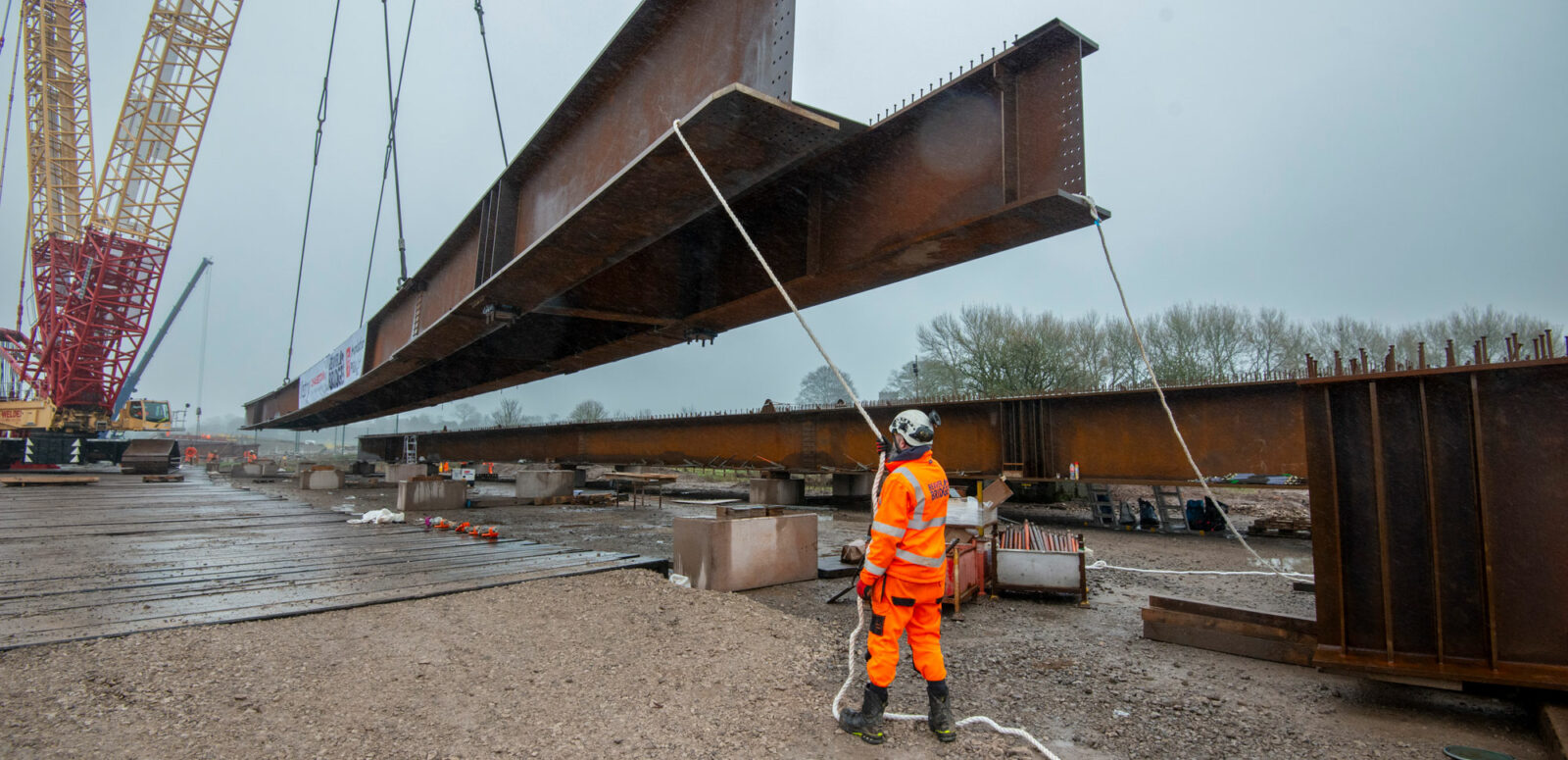

The Infrastructure: A 150m multi-span viaduct containing 510 tonnes of structural steelwork.

The Central Span: A 64-metre crossing of the River Trent, weighing 157 tonnes.

The Side Spans: Symmetrical eastern and western spans of 43 metres each.

Material: Weathering steel for zero-maintenance longevity.

Resilience: 2.6-metre vertical clearance above water levels, supported by six specialist culverts.

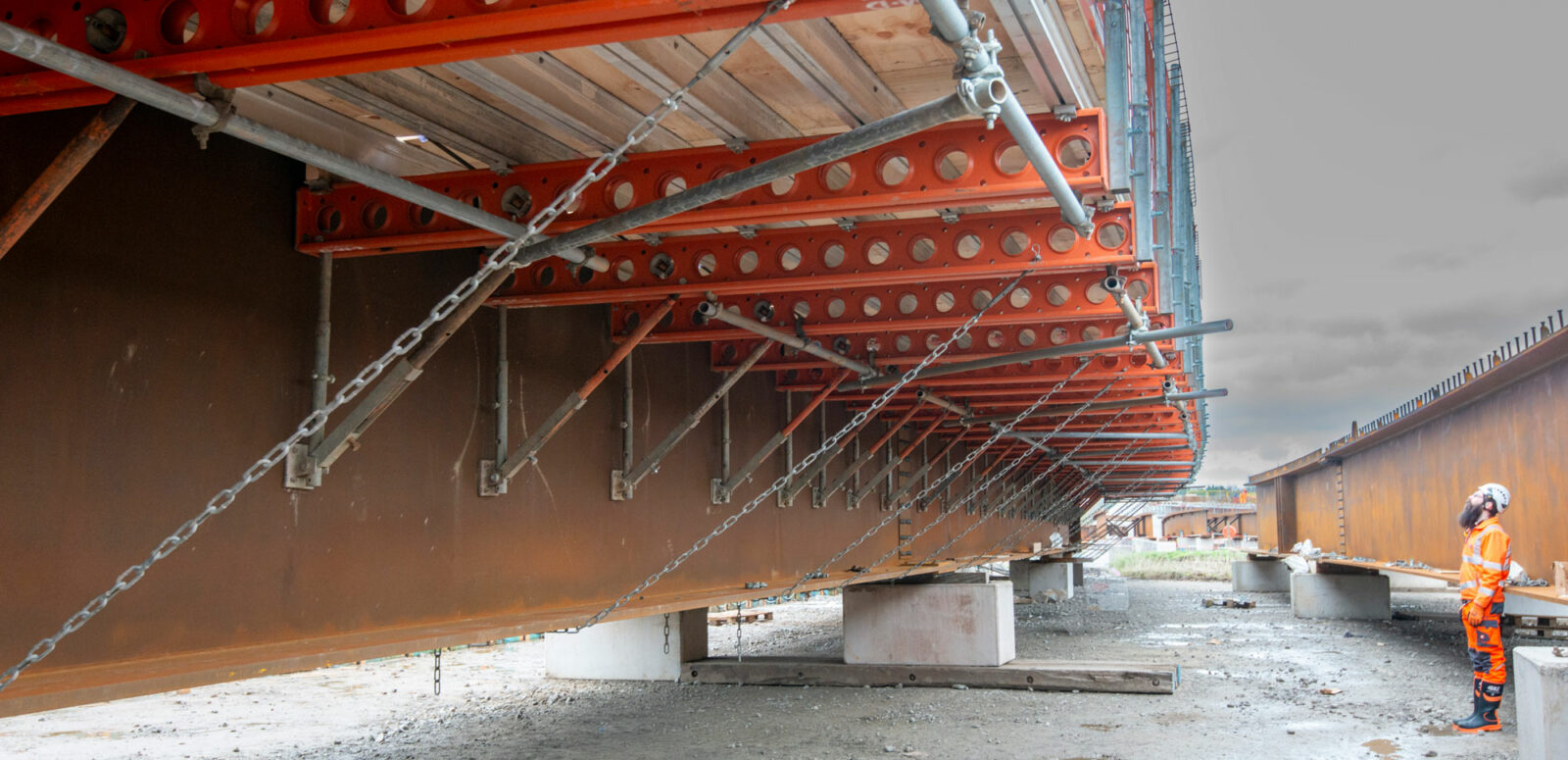

Stepping up to the plate, our installation was a masterclass in technical precision. To mitigate the risks of the February window, we conducted in-person inspections during the production phase and oversaw Jamestown’s full trial assembly in December 2025.

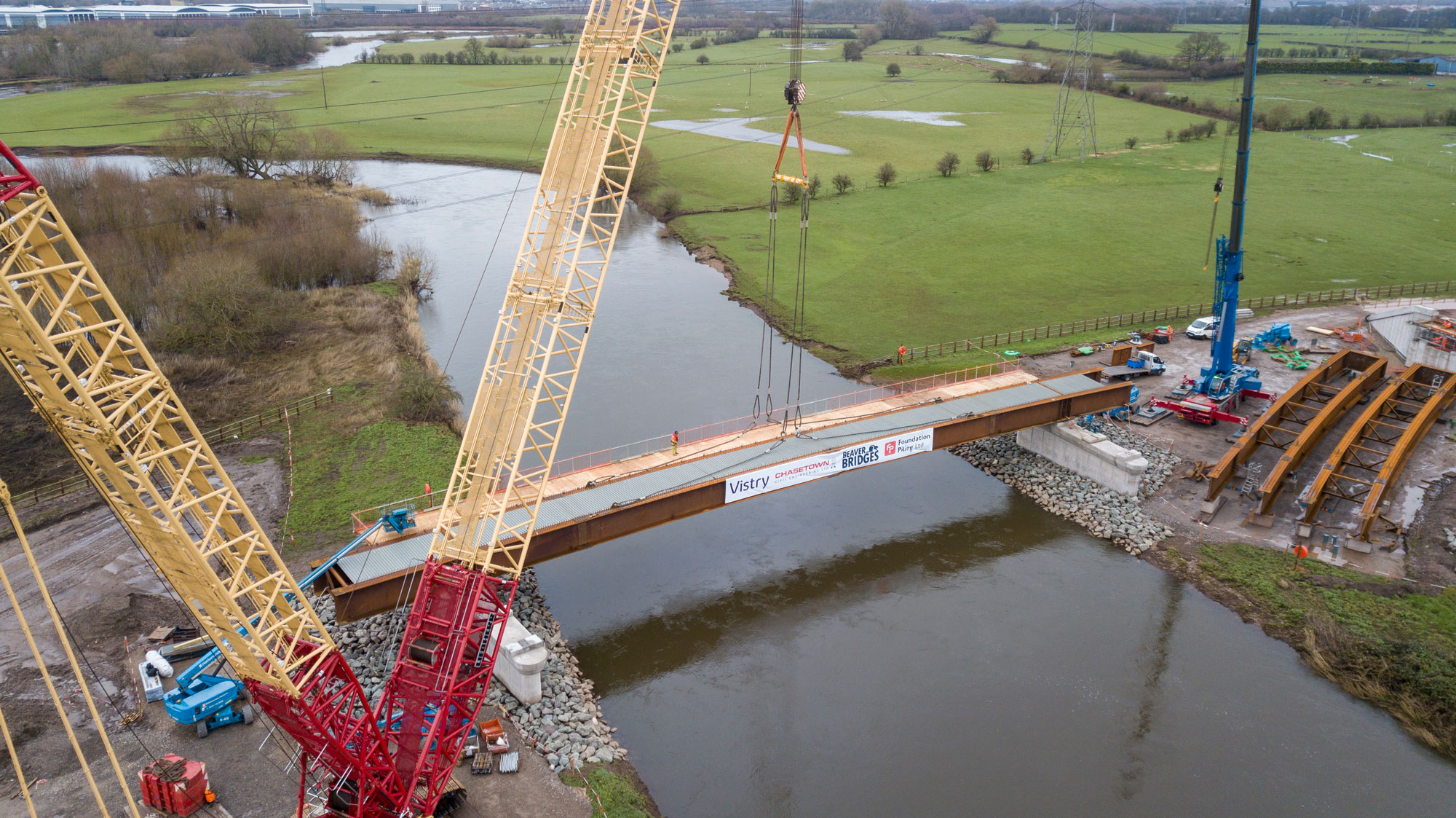

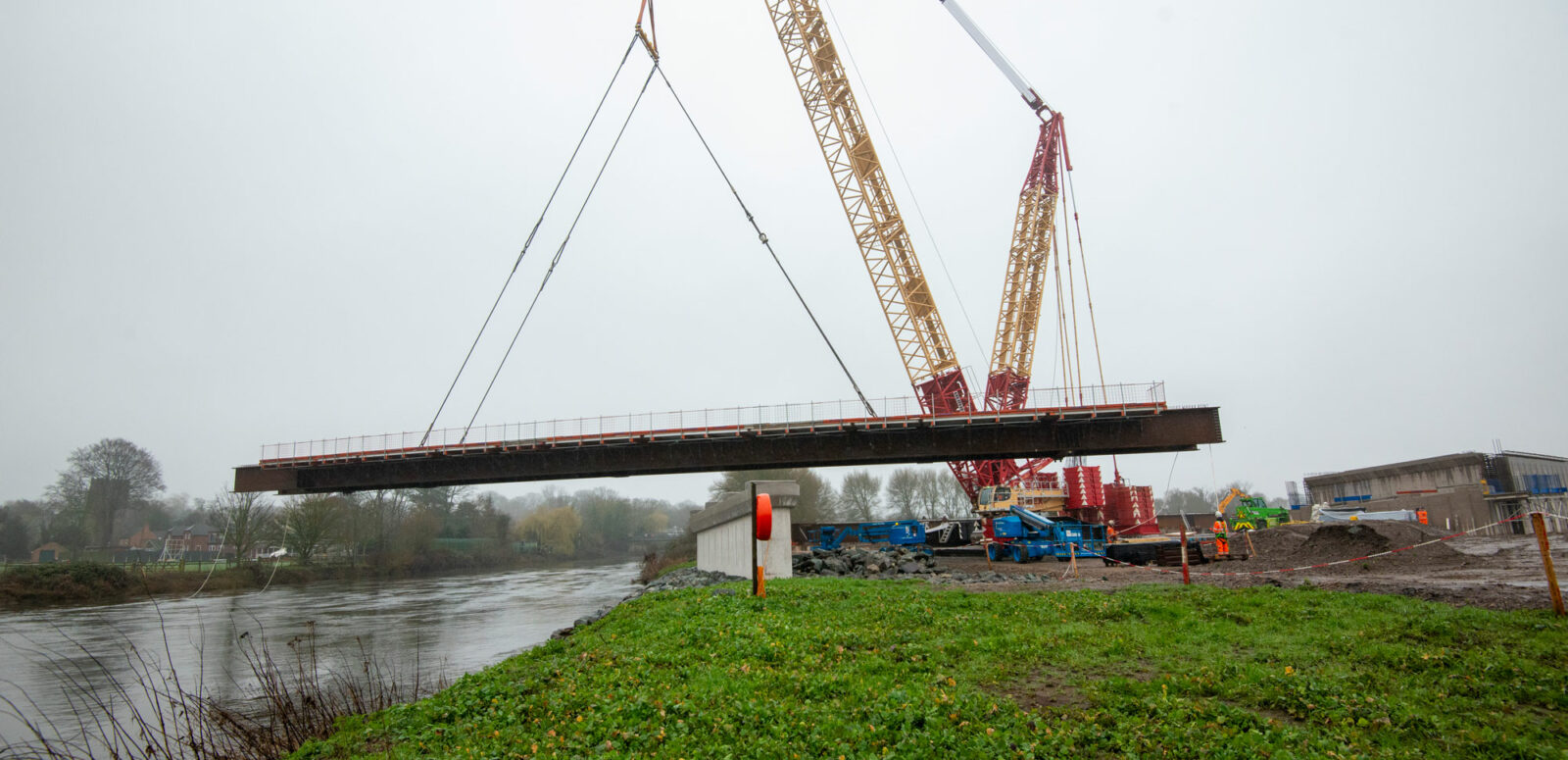

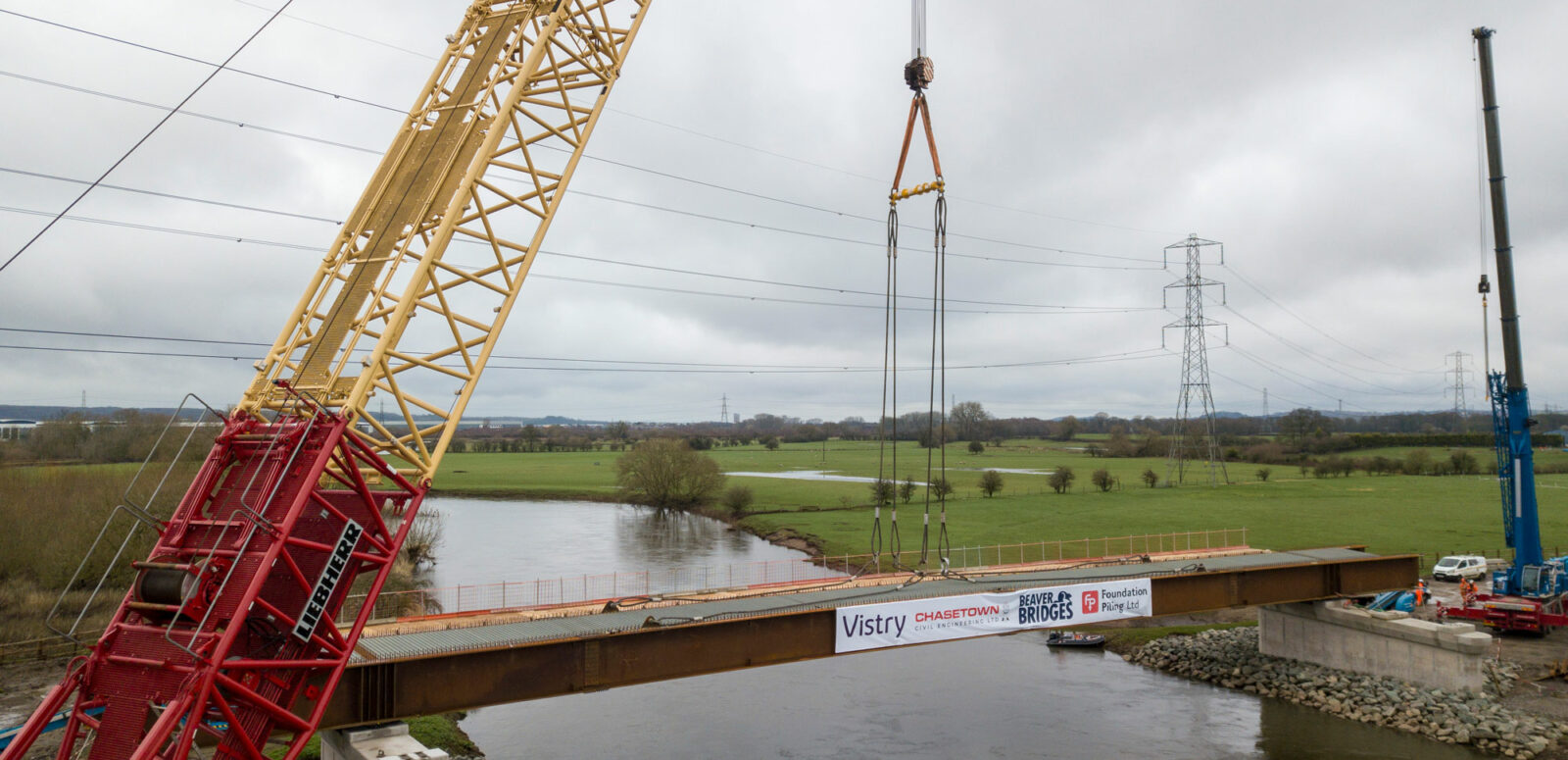

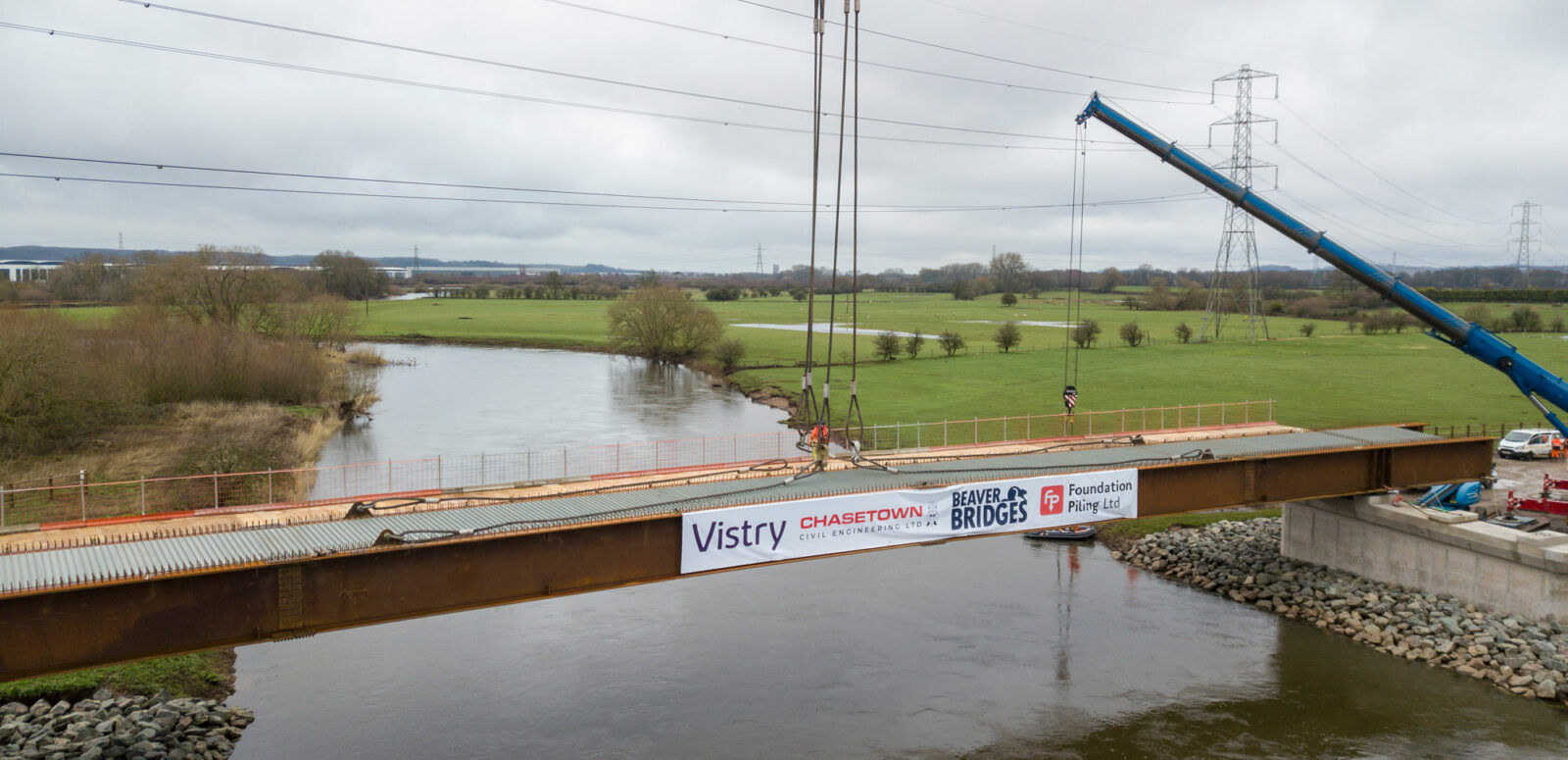

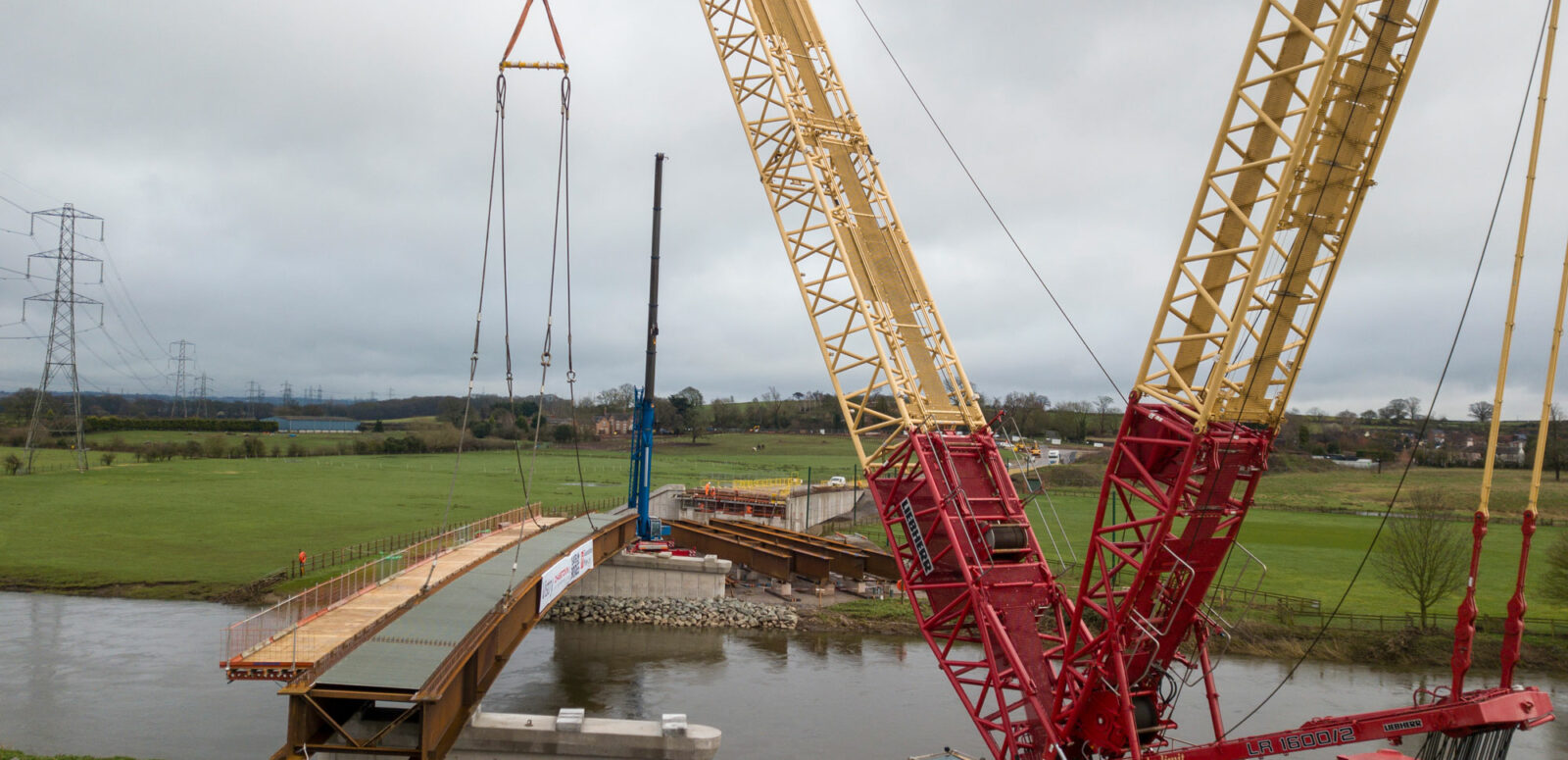

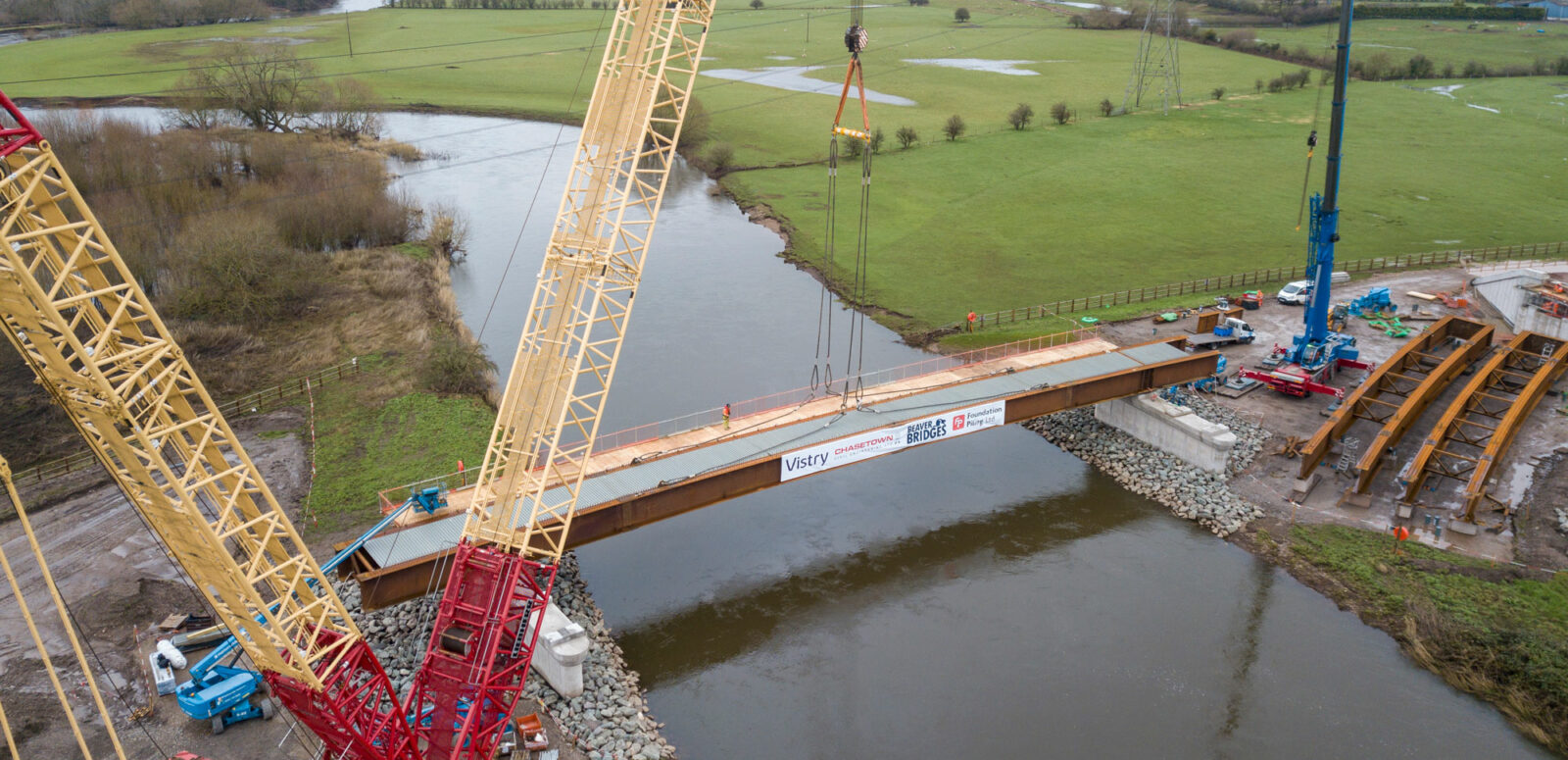

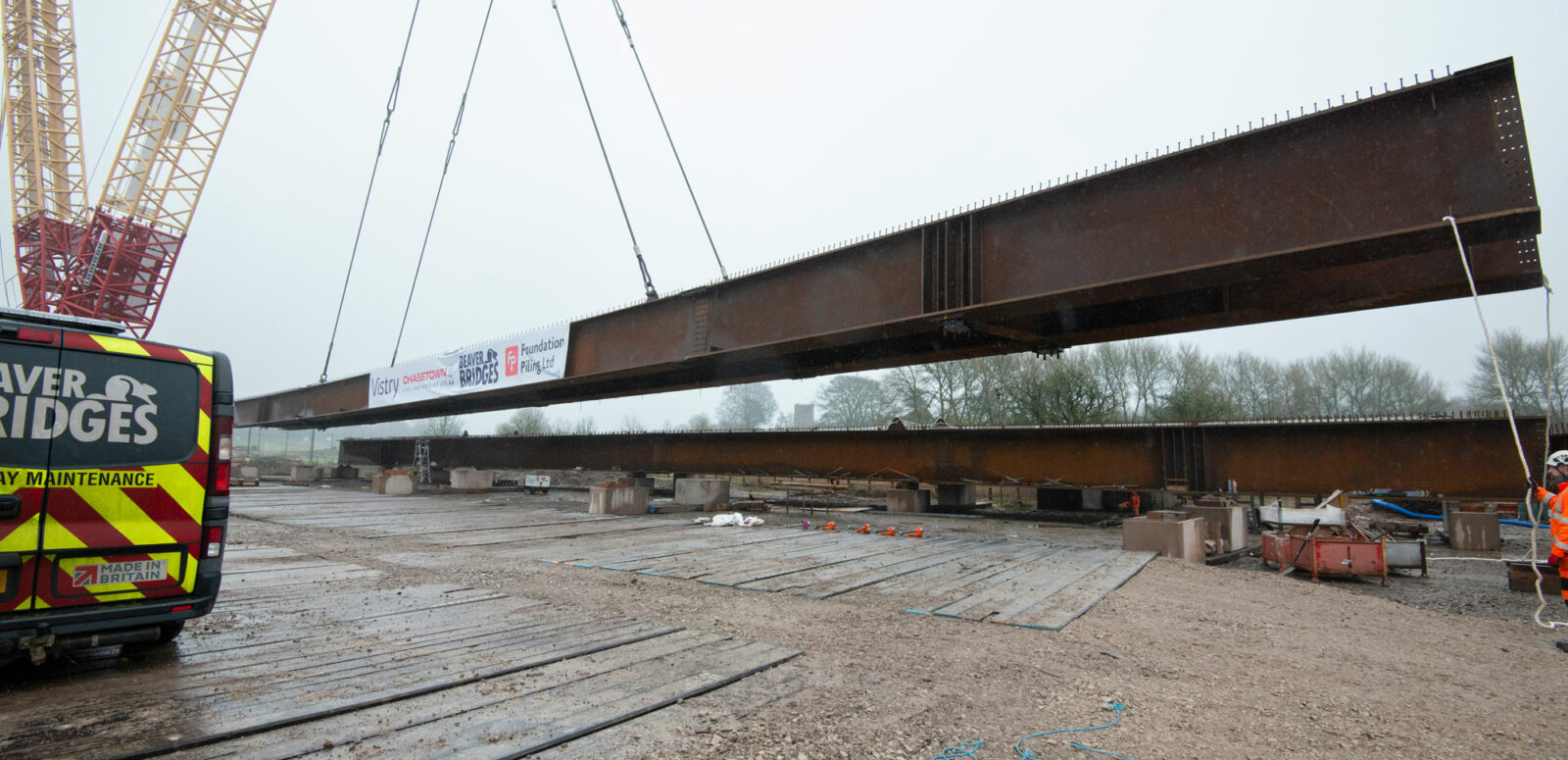

When the weather finally cleared on 27 February, our team deployed a 600-tonne crawler crane to execute a meticulous six-phase lifting strategy. This methodical choreography allowed us to install the massive girders and main deck elements with surgical precision, turning a hostile environment into a landmark success.

The Results

Despite the logistical and environmental hurdles, we successfully completed the first major lift of the new Walton Bridge, proving the resilience of the Shropshire Alliance.

The transformation from a restricted Bailey bridge to a high-capacity highway viaduct acts as a major economic and residential catalyst. As a new strategic link for local commuters and the 2,000-home Dracan Village development, the bridge does more than just diminish a bottleneck; it supports the long-term growth of the entire region.

“Walton Bypass represents another significant milestone for Beaver Bridges,” says Henry Beaver, CEO. “This complex multi-span viaduct, supported by weathering steel main beams to full adoptable highway standards, shows the range and versatility of the business.”



We are proud to have played such a vital role in the delivery of a technically sound, environmentally thoughtful, and structurally graceful piece of infrastructure.
