From concept to completion, Beaver Bridges offers end-to-end services for permanent and temporary bridge projects. Whether you're planning new infrastructure or upgrading existing assets, our in-house teams deliver compliant, cost-effective, and future-ready solutions — on time, every time.
From national infrastructure to private developments, Beaver Bridges supports a wide range of sectors with bespoke bridging solutions. Our experience spans highways, rail, energy, and public sector projects — as well as private estates and commercial schemes. Wherever your project sits, we have the tools, talent, and track record to deliver.
Explore the wide range of bridge solutions delivered by Beaver Bridges. We design and build both permanent and temporary structures for projects of all sizes. With strong engineering expertise and a practical approach, we provide safe, reliable and compliant bridge systems tailored to each project’s needs and environment.
From remote landscapes to live rail environments, Beaver Bridges thrives in complex settings where others hesitate. Our in-house team brings together decades of engineering expertise, ensuring we meet challenges head-on — safely, sustainably, and without compromise.
Beaver Bridges triumphantly executed a high-stakes dual-bridge project for Crest Nicholson in Ipswich, showcasing unparalleled innovation in urban infrastructure. The 45m composite vehicle bridge and 34m pedestrian bridge, spanning active railway lines, unlock access to a transformative 1,000-home Garden Suburb, blending cutting-edge engineering with meticulous logistics.
Innovation at Scale:

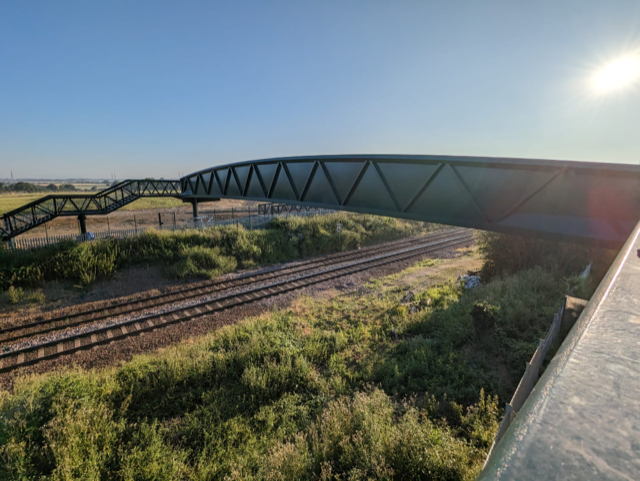

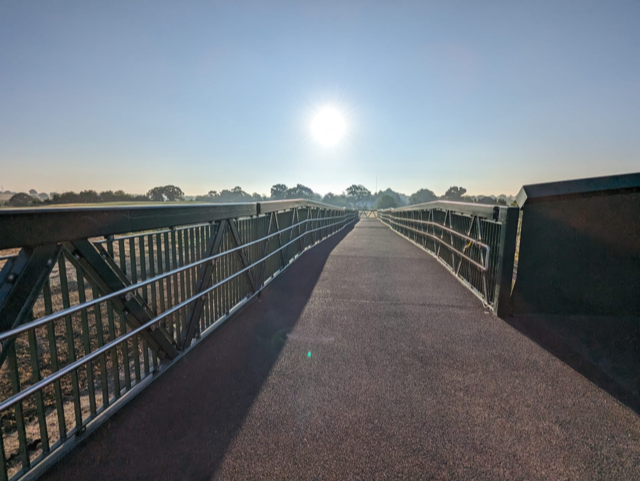

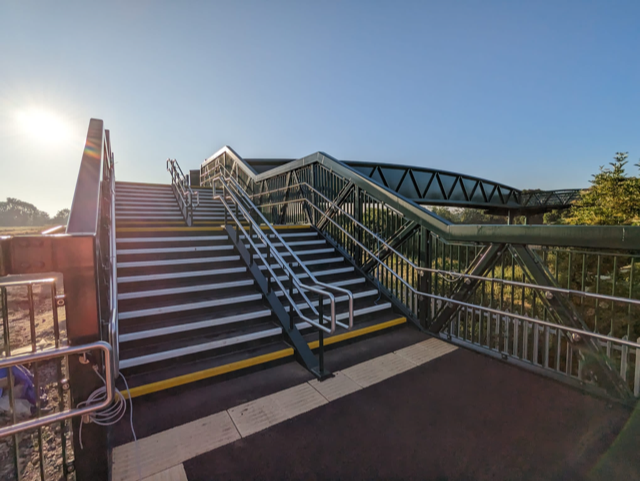

Weathering Steel Mastery: The vehicle bridge’s corrosion-resistant weathering steel and concrete deck ensure longevity, while the all-steel pedestrian bridge features energy-efficient lighting and 100m ramps, prioritising accessibility.

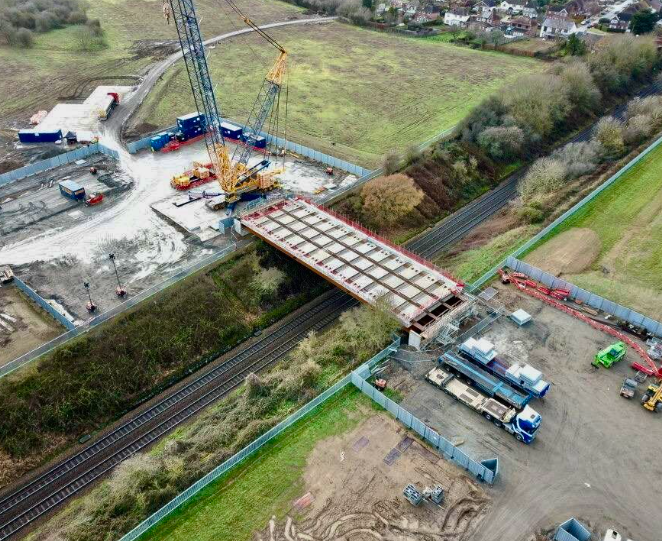

Modular Fabrication: Prefabricated in six sections at Beaver Bridges’ Wigan facility, the vehicle bridge was precision-assembled on-site, minimising railway disruption.
Logistical Triumph:

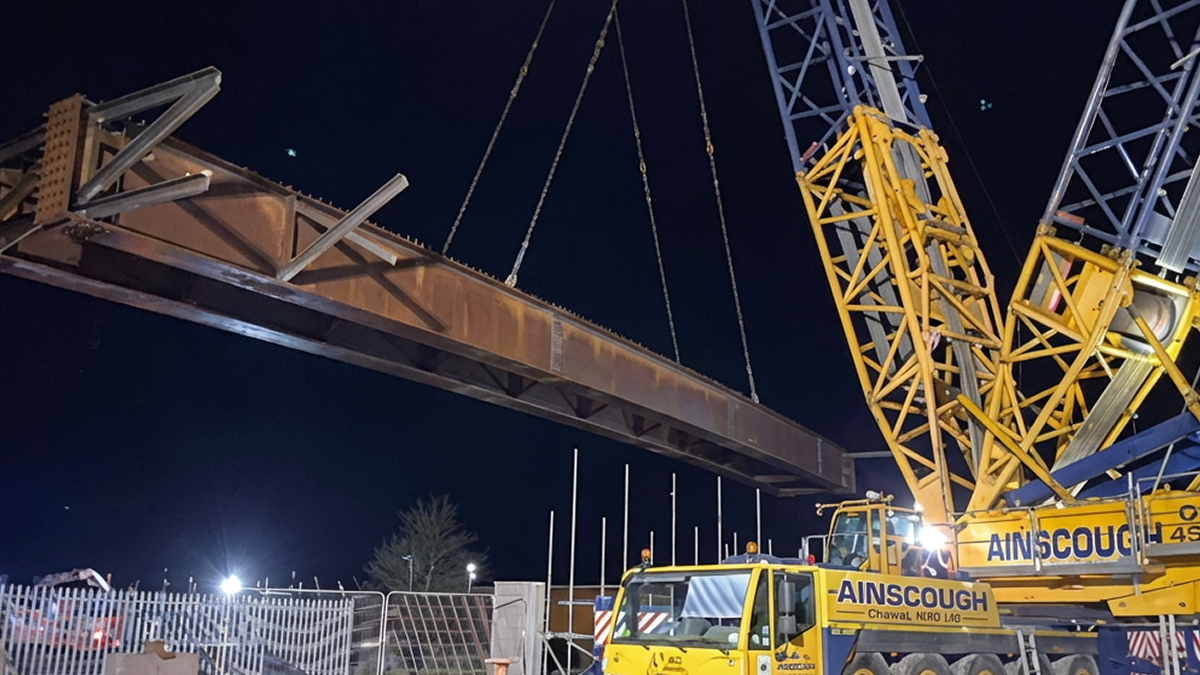

Railway Possession Precision: Securing a 56-hour Christmas 2022 installation window, 160 skilled personnel deployed 9 cranes, telehandlers, and 504 tonnes of steel to complete both bridges 4 hours ahead of schedule—a testament to Beaver Bridges’ rail-sector expertise.
Collaborative Agility:
Stakeholder Synergy: Continuous coordination with Network Rail, Ipswich Council, and Crest Nicholson ensured compliance and safety, supported by onsite Project Managers and a dedicated QS.
Scalable Solutions: Expanded scope—including piled foundations, waterproofing, and eco-friendly devegetation—was seamlessly integrated, reflecting adaptive project management.
Legacy of Innovation:
With 1,524 tonnes of concrete and 400 trackway panels, the bridges epitomise sustainable urban growth, enabling cycle routes, a primary school, and a Country Park. Beaver Bridges’ investment in staff training (PTS, SSSTS) and stakeholder transparency underscores their commitment to community-centric development.
Delivered on budget, ahead of deadline, and to client acclaim, this project cements Beaver Bridges as pioneers in complex, large-scale infrastructure—where ambition meets precision, reshaping Ipswich’s future.
